Case Study 2.1 HPI
TZ
by
Tiffani Zernhelt
·
3 views
·
Updated Sep 25, 2023
Share
Embed
Create your own
Chapters
00:00
Chapter 1
00:11
Chapter 2
00:42
Chapter 3
00:44
Chapter 4
00:47
Chapter 5
01:15
Chapter 6
01:16
Chapter 7
02:47
Chapter 8
02:48
Chapter 9
02:50
Chapter 10
04:44
Chapter 11
04:45
Chapter 12
06:04
Chapter 13
06:05
Chapter 14
07:29
Chapter 15
07:30
Chapter 16
08:18
Chapter 17
Audio Transcript
Auto-generated
00:01 - 00:05
So this is case study 2.1 the Blake company and Mush's
00:05 - 00:11
kitchens for renovations that needed shaping up. I am Miss uh Tiffany
00:11 - 00:13
Zhel. It's gonna take you through
00:13 - 00:16
and we're gonna start with the organization.

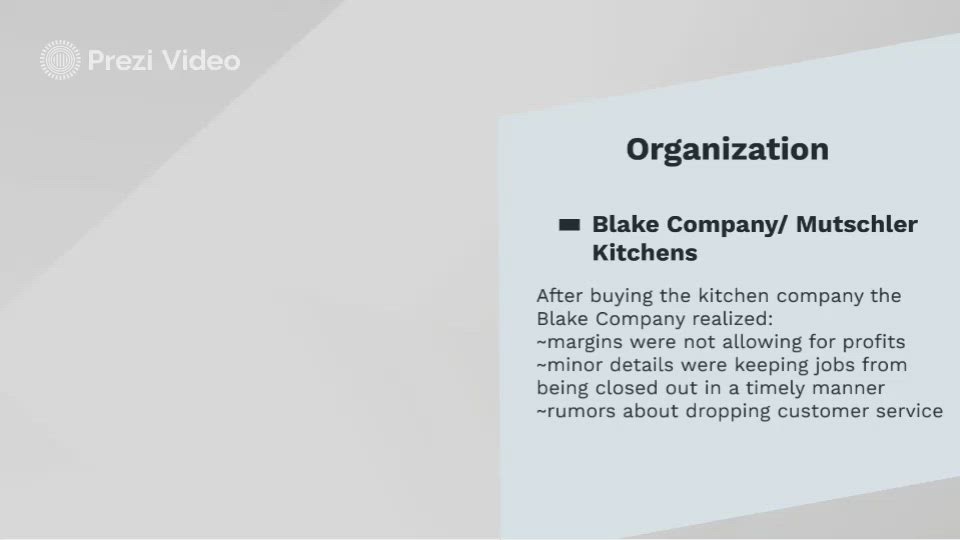

00:16 - 00:22
So the Blake company um decided to buy out the Kitchen Innovation Company.
00:22 - 00:23
But then once they did,
00:23 - 00:26
they realized that the margins on the jobs were
00:26 - 00:29
not allowing for overall profits from the jobs.
00:30 - 00:33
They also realized that it was the little details that were
00:33 - 00:37
keeping jobs from being closed out in a timely manner.
00:37 - 00:40
And also they had heard rumors about their
00:40 - 00:44
overall customer service dropping within the community.
00:45 - 00:48
So what method did they use to diagnose and address this problem?
00:48 - 00:50

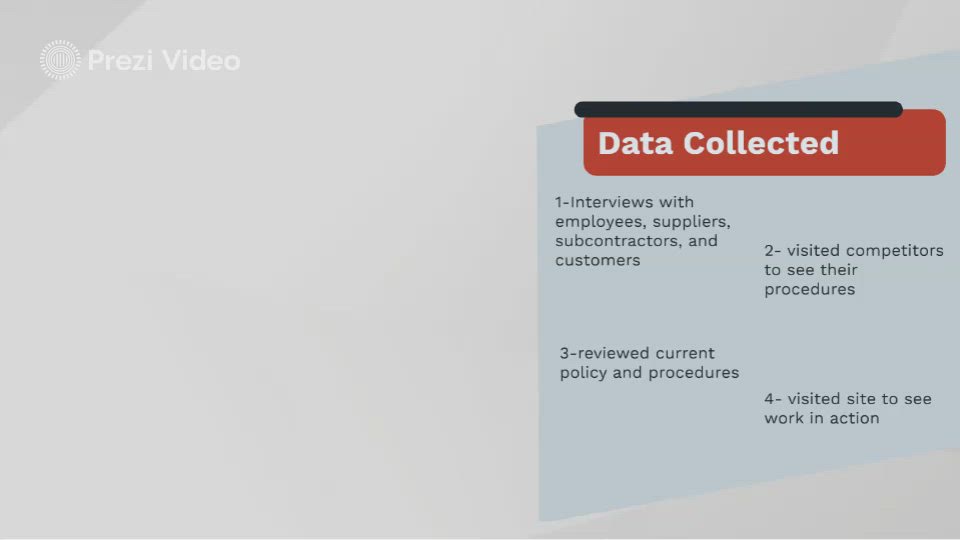

Well, let's look at the data collected.
00:50 - 00:54
So first they interviewed the employees, the suppliers,
00:54 - 00:58
the subcontractors and the customers to get their feedback.
00:58 - 01:02
They also visited competitors to see what their uh
01:02 - 01:05
processes and procedures were and how they worked.
01:05 - 01:07
They also reviewed all the current
01:07 - 01:11
policy and procedures within the kitchens company
01:11 - 01:16
and they visited the work sites to see the progress in action.
01:18 - 01:23
Well, from this, they were able to establish three goals,
01:23 - 01:25
one to increase customer satisfaction,
01:26 - 01:29
two to increase the profit margin for each job and
01:29 - 01:33
three to decrease the uncertainty and the number of crises at
01:33 - 01:38

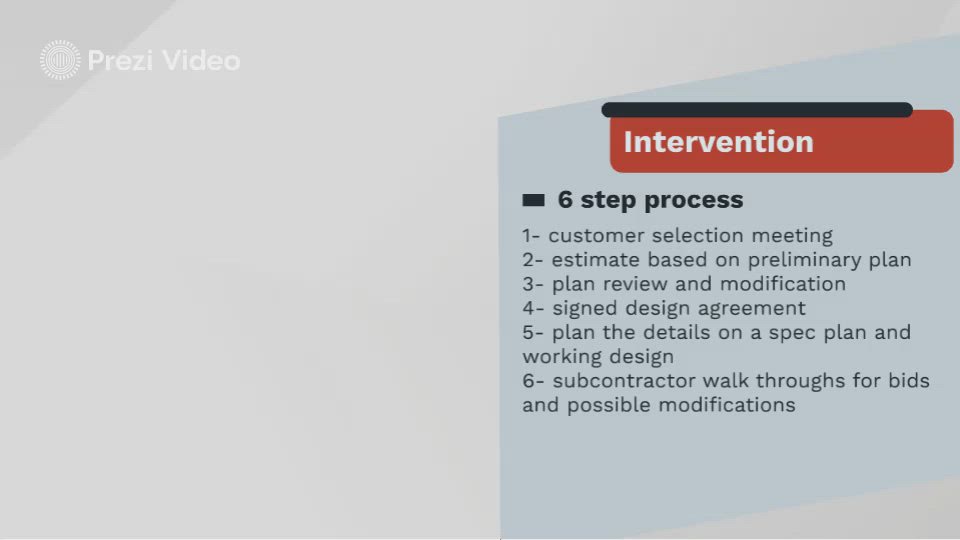

the construction sites by putting in this six step process.
01:38 - 01:40
First step,
01:40 - 01:45
it would begin things with a customer selection meeting in which they would
01:45 - 01:47
uh go through their needs.
01:48 - 01:52
Second step is a preliminary plan would be created by the
01:52 - 01:56
designers and the original estimate would be based off of that.
01:57 - 02:01
The third step would be between the designer and
02:01 - 02:05
the customer to modify that plan if needed.
02:06 - 02:08
If they all agreed,
02:08 - 02:11
then the fourth step would be a signed design
02:11 - 02:15
agreement that would show a commitment between the customer
02:15 - 02:16
and the company.
02:17 - 02:18
Fifth step,
02:18 - 02:23
once that would be signed is that all the individual details would be planned
02:23 - 02:26
and put on a spec plan and a working design
02:26 - 02:31
so that it would decrease the amount of confusion at the actual site.
02:31 - 02:34
And then the last step would be subcontractors walking through,
02:35 - 02:39
going over the designs so that they could create a bid
02:39 - 02:43
and if any modifications were to be made at that time,
02:43 - 02:44
then
02:44 - 02:48
a change order could be created.
02:49 - 02:53

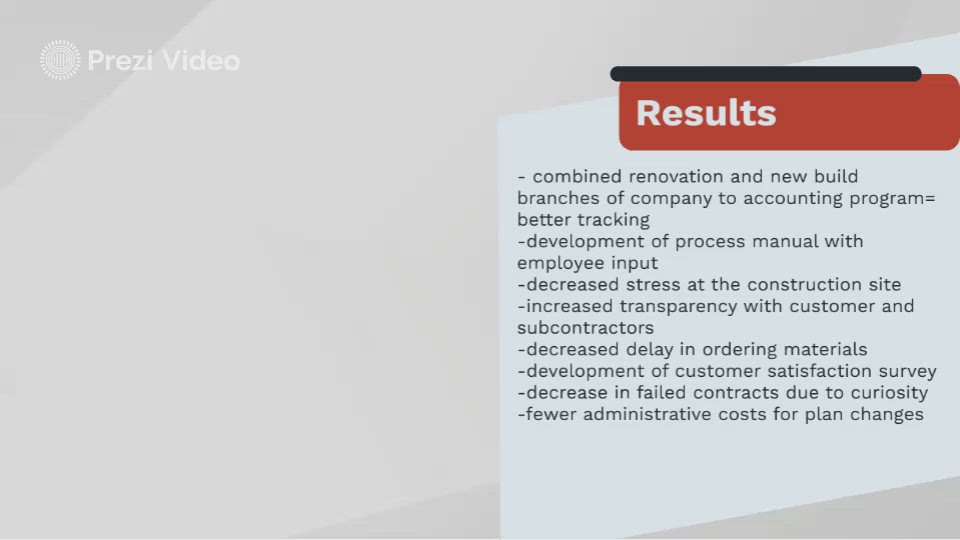

So after diagnosing what results were found,
02:53 - 02:55
uh lots of results found in this one.
02:55 - 02:56
First,
02:56 - 02:59
they decided to combine the renovation and the new
02:59 - 03:02
build branches of the company into the same accounting program
03:02 - 03:07
that allowed them to better track finances and expenses.
03:08 - 03:14
There was also a development of a process manual with the employee input,
03:15 - 03:19
this would outline the processes and procedures and put it into black and white.
03:20 - 03:24
There was also a decrease in the stress at the construction site
03:24 - 03:29
with the spec plans and the working designs. Things were known ahead of time.
03:30 - 03:35
There was increased transparency between customer and subcontractors.
03:35 - 03:38
So if a modification was needed between what the customer wanted
03:38 - 03:43
and the subcontractor could actually do that was taken care of ahead of time.
03:43 - 03:47
There was a decrease in the delay in ordering materials.
03:47 - 03:52
With the completion of a spec plan, those orders could be put in in a timely manner.
03:52 - 03:57
They also developed a customer satisfaction survey that
03:57 - 04:00
could be completed at the end of each job
04:00 - 04:05
to provide detailed feedback on that job. Specifically,
04:06 - 04:10
there was a decrease in failed contracts due to just pure curiosity.
04:10 - 04:13
So by having the agreement signed
04:13 - 04:14
that
04:14 - 04:17
um formed a commitment between the customer and the company,
04:18 - 04:19
there weren't an
04:19 - 04:24
uh wasted time creating designs for people who were really just curious about it.
04:25 - 04:27
There was also a decrease um
04:27 - 04:31
in administrative cost for plan changes.
04:31 - 04:36
Since the plan is reviewed numerous times throughout the six step process,
04:36 - 04:37
the
04:37 - 04:41
um administrative changes were fewer far between and that
04:41 - 04:45
required less time and effort on the committee itself.
04:46 - 04:47

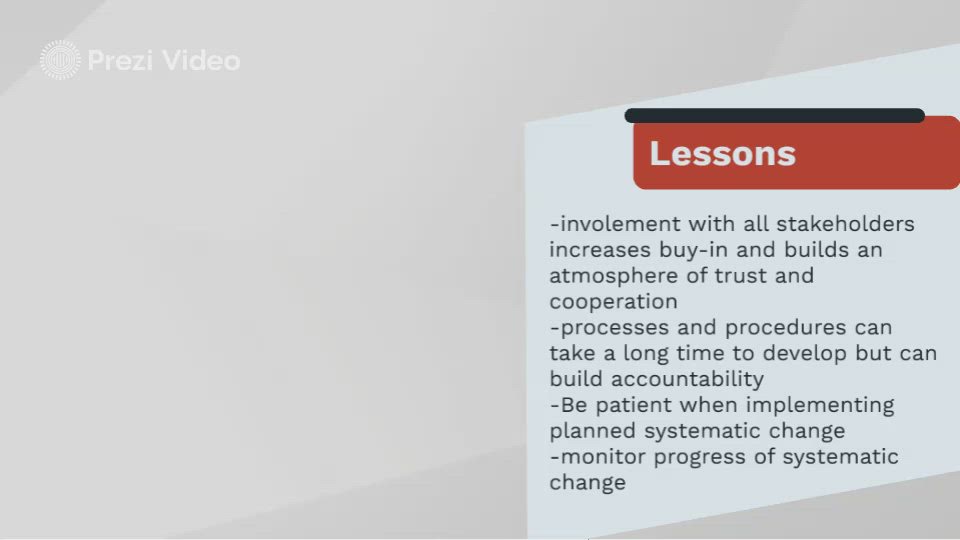

So what lessons were learned?
04:48 - 04:48
First of all, that,
04:48 - 04:53
the involvement with all stakeholders really does increase the buy-in
04:53 - 04:57
and it builds an atmosphere of trust and cooperation.
04:57 - 05:03
Although some of the designers were a little hesitant at first by involving them
05:04 - 05:07
in the uh process, manual creation
05:07 - 05:11
and the uh steps to the intervention,
05:12 - 05:14
it's increased their buy in
05:14 - 05:15
and
05:15 - 05:17
implementation later on
05:17 - 05:19
these processes and procedures.
05:19 - 05:23
Since they are systematic, they can take a long time to develop.
05:23 - 05:26
There's gonna be some trial and error in there,
05:26 - 05:30
but that can also build in accountability.
05:31 - 05:33
So the accountability of the customer to the company,
05:34 - 05:37
the accountability of the designer to the customers and
05:37 - 05:40
the accountability to the subcontractors to the company.
05:41 - 05:44
When implementing these planned systematic changes,
05:44 - 05:47
especially of processes and procedures like for this company,
05:47 - 05:51
they've been in business 25 years with no pro processes.
05:51 - 05:54
You have to be patient. It's gonna take some time.
05:54 - 05:56
They were a little hesitant at first but be
05:56 - 06:00
sure to monitor that progress of the changes.
06:00 - 06:02
You don't know if anything's getting better
06:02 - 06:05
or worse unless you're actually monitoring it.
06:06 - 06:09

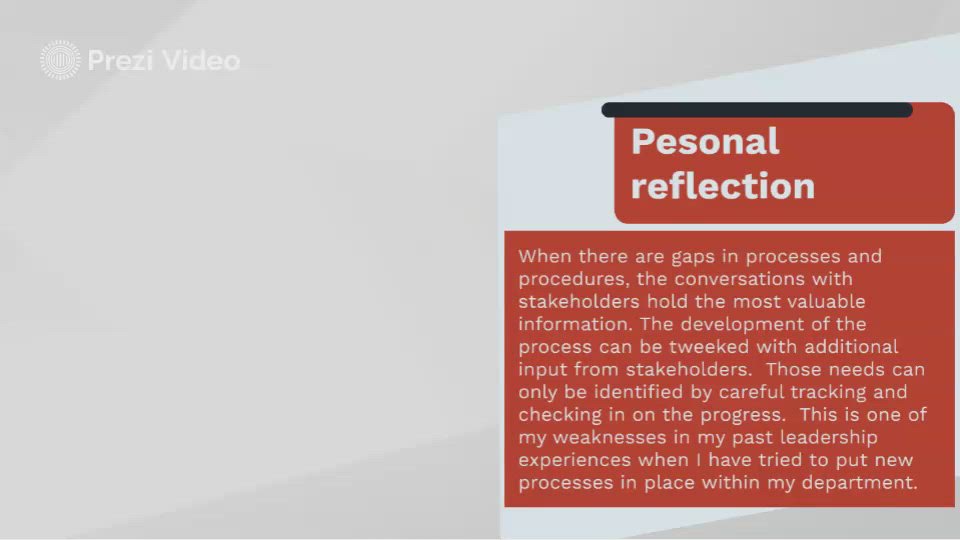

So in thinking about my own personal reflection,
06:10 - 06:13
when there are gaps in processes and procedures,
06:13 - 06:15
conversations with the stakeholders really do
06:15 - 06:17
hold the most valuable information.
06:18 - 06:21
So think of it like boots on the ground,
06:21 - 06:24
they're gonna know that something is good or bad in the daily functioning
06:25 - 06:26
of the organization
06:26 - 06:30
much faster than those in management or leadership.
06:30 - 06:33
The development of these processes can be
06:33 - 06:35
tweaked with additional input from stakeholders.
06:35 - 06:38
So you need a process in place to actually
06:38 - 06:42
be able to capture that feedback and to provide
06:42 - 06:44
them the opportunity to give it to you.
06:45 - 06:48
Um, I do know that this is one of the weak,
06:48 - 06:53
my personal weaknesses in my past leadership experiences when I've tried to put um,
06:53 - 06:56
new processes or procedures in place with my department.
06:57 - 07:00
Um, a lot of times I'll put something in place because I
07:00 - 07:04
would think or feel that, uh I would think that I saw a need
07:05 - 07:07
and whenever it actually comes down to it,
07:07 - 07:12
what I would put in a place is, was not what the department needed.
07:12 - 07:13
Um
07:13 - 07:14
So
07:14 - 07:20
especially in this program, with the use of needs assessments in previous um
07:20 - 07:22
graduate courses,
07:22 - 07:24
I have learned that
07:24 - 07:27
you really have to get to the stakeholders
07:27 - 07:29
themselves to find out what those needs are,
07:29 - 07:31
not just relying on myself.
07:31 - 07:32
And
07:32 - 07:34

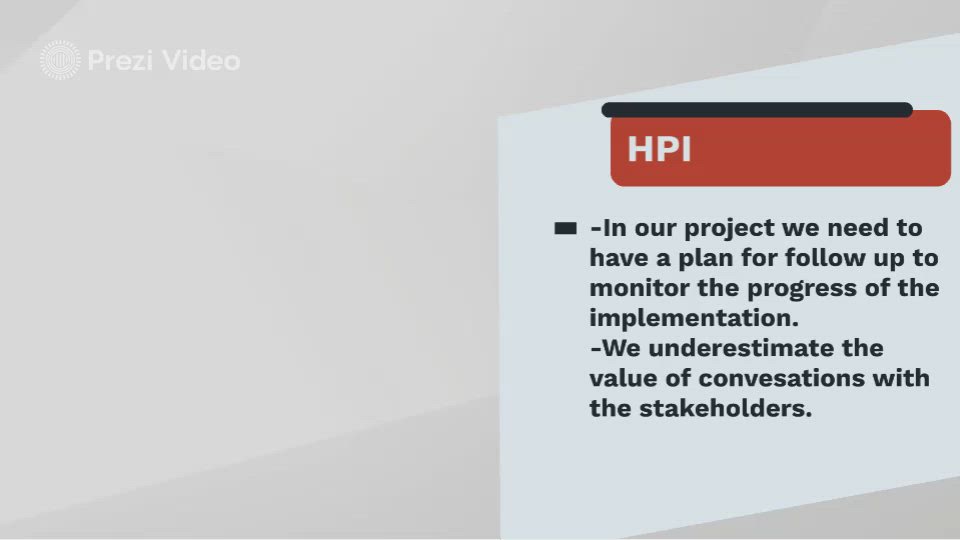

how can we apply this to our HP I project?
07:35 - 07:36
Um In our project,
07:36 - 07:40
we need to make sure that we have a plan for follow up and an opportunity for
07:40 - 07:43
those stakeholders to provide feedback to us so
07:43 - 07:46
that we can monitor the progress of implementation of
07:47 - 07:49
our uh performance interventions.
07:50 - 07:52
And also we really did underestimate the
07:52 - 07:54
value of conversations with the stakeholders.
07:54 - 07:56
Even in our team meeting,
07:56 - 08:00
it was discussed how we wanted to talk to all of those involved
08:00 - 08:04
pretty much except the people that were gonna be doing the work.
08:04 - 08:07
You know, we wanted to talk to the students, we wanted to talk to the tech team.
08:07 - 08:10
Uh But we were just gonna give the teachers a survey.
08:10 - 08:10
Well,
08:10 - 08:12
that might not be the best avenue for them
08:12 - 08:16
to share the vital information of what truly is
08:17 - 08:18
creating that need.
08:19 - 08:20
So
08:20 - 08:24
that is case study 2.1 on the Blake Company and the Mush
08:25 - 08:26
kitchens.
See full transcript
